2026 is on course to be a record year for UK electric vehicle sales. Battery-electric cars took 30% of new registrations in June, the highest monthly share on record, and the country passed two million electric cars on the road in May. By any headline measure, the market is winning.
It's also on course to be a record year for charge point operator failures. One UK fleet-charging specialist, which had installed tens of thousands of commercial chargers across dozens of countries for major retail and logistics customers, entered administration in April with the majority of its staff made redundant immediately. A well-regarded on-street charging network, backed by a nine-figure public-sector financing facility, followed it into administration three months earlier. Neither collapse was a surprise to anyone reading their accounts: both had auditors flagging going-concern uncertainty in the same set of filings that later proved to be their last.
These two failures are not outliers. They're the visible tip of a sector-wide problem that shows up, in one form or another, in almost every UK charging operator's Companies House filings. Understanding why is the difference between building a site that compounds in value for a decade and building one that becomes an anchor around the balance sheet within three years.
A Consolidation Wave, Not a Death by Demand
Based on a review of publicly filed financial data across the UK charging market, rather than the press releases, a consistent pattern emerges: almost none of these operators are self-financing from operating cash flow. Several disclosed net liabilities in the tens of millions of pounds in their most recent accounts, cash reserves ranging from the low hundreds of thousands to a few million pounds, and in more than one case, accounts filed months after the statutory deadline. One listed European operator closed its financial year with tens of millions in negative equity, only a few million pounds in cash, and a formal going-concern qualification tied to a court-supervised restructuring plan.
None of this means the sector is collapsing outright. It means the sector is being kept alive by continuous injections of equity, private capital and government funding — National Wealth Fund financing, sponsor-backed PE structures, oil-major balance sheets — rather than by the underlying economics of selling electricity to drivers. The market has not yet validated that public charging, on its own, is a sound business at the utilisation levels most sites are currently running at.
The counter-example is instructive. At least one major UK network's group pre-tax loss also widened significantly over the same period — on paper, a worse number than the year before. But underneath that headline, gross margin nearly doubled, network-level EBITDA turned solidly positive, and the loss itself was driven by a one-off impairment and rising depreciation on a fast-growing asset base, backed by a nine-figure facility that carried one of the first sustainability-linked ratings of its kind for UK EV charging. The difference between an operator like that and the ones that collapsed isn't optimism. It's balance sheet depth, funded expansion discipline, and site selection — the same three things that separate a future-proof infrastructure investment from a stranded one at any scale.
The Two Numbers Explaining Why
Two figures explain most of what's happening underneath these balance sheets.
The first is utilisation. UK public chargers are actively delivering a charging session for roughly 8% of a 24-hour period on average — about two hours a day — according to Zapmap's tracking data. The industry rule of thumb for a rapid or ultra-rapid site to be commercially healthy is utilisation north of 50%. Most sites are nowhere close, and independent analysis from Field Dynamics and LCP Delta both describe utilisation per charger as flat, even as the number of chargers keeps growing — the network is being built out faster than usage is intensifying per device.
The second is where charging actually happens. Roughly 80% of current UK EV owners have home charging access, largely because around two-thirds of UK households have a driveway or dedicated off-street parking. Public charging's addressable transaction volume is therefore structurally smaller than the "two million EVs on the road" headline implies: it's competing for the roughly one-third of owners without home charging access, plus everyone's occasional long trips, not for the whole market.
Put together: a business model that needs 50%+ utilisation to break even is running at roughly 8%, competing for a structurally limited share of total charging demand, on hardware and grid capacity that was often provisioned for a much larger addressable market than actually shows up.
And the Cost Stack Is Working Against Every Site
The commodity cost of electricity is not what's squeezing margins. UK non-domestic electricity runs around 23.8p/kWh; what's actually escalating is everything layered on top of it. Standing charges for rapid and ultra-rapid connections are up 462% since 2021/22 and now account for as much as 70% of total energy cost at a typical rapid site, according to Cornwall Insight analysis commissioned by ChargeUK. Transmission charges (TNUoS) for large-demand sites are rising a further 64% from April 2026. Public charging still carries 20% VAT, against 5% for charging at home, and a tribunal ruling that could equalise this is currently under HMRC appeal, with 20% remaining in force in the meantime.
The consequence, per the same Cornwall Insight/ChargeUK analysis: at low-utilisation sites, an operator's total cost can run up to 60% above what the driver actually pays — a structurally loss-making session, before a single pound of hardware amortisation, land lease or staff cost is counted. Even at the best-performing sites, the margin over cost is only around 10%. There is no reserve in a 10% margin to absorb a wholesale price spike (UK day-ahead power hit £137.21/MWh in March 2026), a slower-than-planned fleet ramp, or a competitor opening 400 metres away. That thin a margin is exactly the mechanism that turns "utilisation came in lower than the model assumed" into "administrators appointed" within a couple of difficult quarters.
The Vehicle Mix Underneath the Site Is Also Moving
Even where the demand and cost picture is manageable, the vehicles a site needs to serve are changing faster than most infrastructure investment cycles. Passenger cars are the most advanced segment, at 30% of new registrations but still only around 6% of the cars actually on the road — most of the growth is still ahead. Vans are running at roughly 40% of the pace the ZEV Mandate requires, a gap that's widening rather than closing. Heavy goods vehicles are barely started: zero-emission HGVs were about 1% of new registrations in Q2 2026, and total volumes actually fell year-on-year in the first half, held back mainly by immature megawatt charging infrastructure. Buses are the outlier, at 8.1% of the fleet and accelerating fast — but driven by local authority procurement mandates, not organic demand.
Construction and industrial plant equipment sits furthest behind in terms of published UK data — there's no reliable national penetration figure yet, because the category is too early for anyone to have started measuring it properly. But early does not mean absent. Neutron's own deployment in Qingdao, China, is already charging a heavy tanker truck through a liquid-cooled NSNM1600LC megawatt terminal, and a LiuGong electric wheel loader through a 480kW NSNF0021MU480LCD Master Unit, on the same modular platform. Those two vehicles have almost nothing in common in terms of duty cycle, connector requirement or siting constraints — and neither looked anything like a "standard EV" when the site was specified. That's the point: a site designed around today's vehicle mix, on fixed-rating hardware, is a bet that the mix won't change. Every trend in this section says it will.

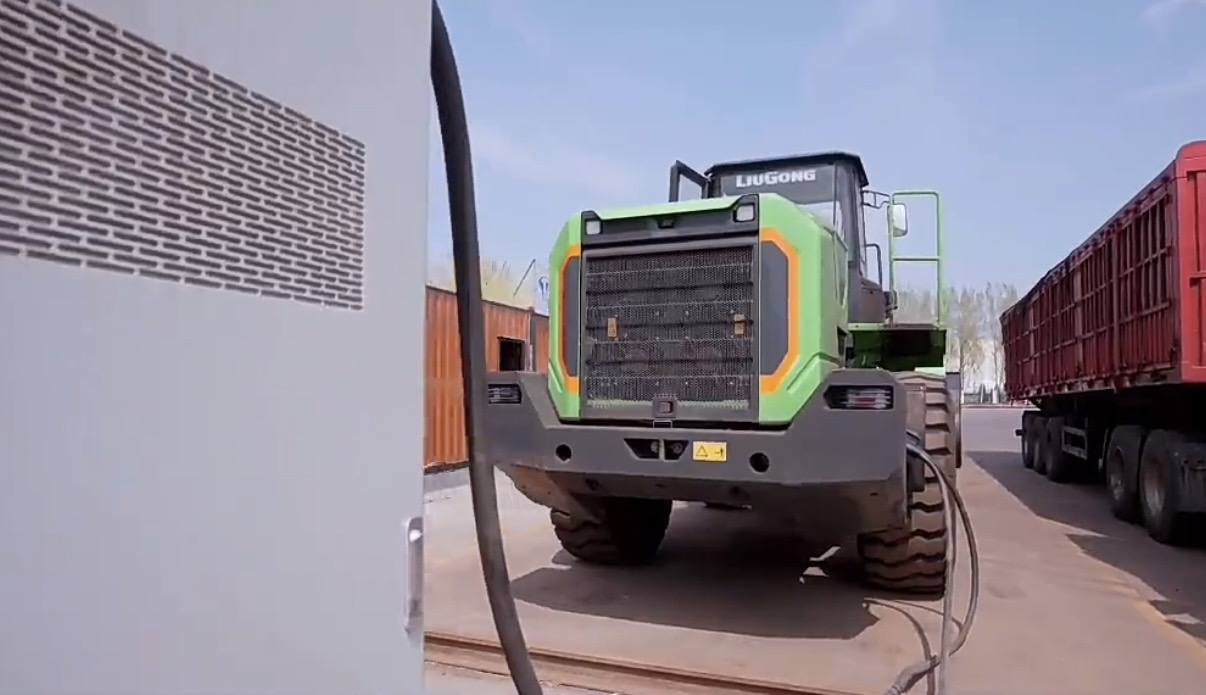

A LiuGong electric wheel loader drawing power from a Neutron 480kW Master Unit — a vehicle type and duty cycle that didn't exist as a mainstream charging customer when most fixed-rating public chargers were specified.
The 50kW Ghost Still Haunting the UK Network
Here is the concrete version of the stranded-asset problem. 50kW DC rapid charging was the mainstream public charging specification in 2020. It is now close to unusable for most current-generation EVs, which expect charging curves well into triple digits. An operator who financed a 50kW installation on a payback model assuming steady utilisation over its service life is now sitting on an asset that is simultaneously unpaid — because network-wide utilisation has averaged around 8% of the day, nowhere near the breakeven level the original business case assumed — and obsolete, unable to attract the vehicles that would actually generate the revenue needed to pay it off in the time it has left.
This isn't a one-off historical accident. It's already repeating one rung up the power ladder. 240kW dual-gun HGV charging was the mainstream specification just two to three years ago and is already considered undersized for the newest heavy trucks entering service. One UK motorway service network has already expanded its rapid-charging capacity by nearly 290% to keep pace, and another major operator has already moved its flagship hubs to 400kW bays — the industry publicly admitting the same lesson a second time: hardware specified to today's fleet has a commercial shelf life measured in single-digit years, not the 10–15 year asset life most capex is underwritten against.
What "Future-Proof" Actually Has to Mean
Not a marketing word. Four concrete engineering and commercial decisions, made before the first cable is pulled:
Modular, shared-power hardware
A master-satellite architecture pools power and allocates it on demand, rather than fixing a rating per bay. An 8-bay depot fitted with eight 400kW integrated chargers needs a transformer sized for 3,200kVA to cover the worst case of all eight running simultaneously; the same 8 bays served from a shared 2.5MW pool need only around 2,500kVA, because capacity is allocated to whichever bays are actually charging. When higher-power vehicles arrive, the response is to add a satellite terminal or a master unit power module — not to replace the site.
Grid connection sized for headroom, not for day one
The DNO connection is the single hardest and slowest part of the entire project to change later — it typically takes months to years and tens to hundreds of thousands of pounds to reinforce. It should be the part of the plan with the longest time horizon, not the part value-engineered down to the minimum that satisfies today's vehicle count.
A revenue layer for the years before drive-up demand breaks even
A site sitting idle 92% of the day is still paying standing charges every hour of it. Battery storage and a software platform turn that idle capacity into flexibility revenue, demand response income and off-peak arbitrage instead of a pure cost. More than one UK operator is already using battery storage to fund a discounted off-peak tariff, or to run a multi-megawatt buffer at a major hub — buying time for utilisation to catch up to the business case without bleeding cash in the meantime.
A connector and siting strategy that doesn't assume one vehicle type
A passenger car bay, an HGV bay and a piece of electrified construction plant have different duty cycles, different connectors, and often different siting requirements — fixed civil works versus a semi-mobile master unit that can move with the job. Specifying a generic "charger" for all of them is how sites end up over-provisioned in one dimension and unable to serve the customer that actually turns up in another.
Two Ways to Spec a Site
| Decision | Cheapest-today spec | Grid-first, future-proof spec |
|---|---|---|
| Hardware architecture | Fixed-rating integrated chargers | Modular shared-power, upgradeable in place |
| Grid connection | Sized to today's vehicle count | Sized with headroom and a staged upgrade path |
| Revenue in low-utilisation years | None — idle capacity is pure cost | BESS + software layer monetises idle capacity |
| Upgrade path for new vehicle specs | Full hardware replacement | Add a satellite terminal or power module |
| Real-world outcome | The 2020-era 50kW charger: unpaid and obsolete | Asset value compounds as fleet and tariffs evolve |
How Neutron Builds Around This
Every engagement starts with the grid, not the hardware: an assessment of available capacity, DNO connection cost and timeline, and realistic phasing, before a single unit is specified. From there, the architecture scales with the customer rather than being replaced by them — the Modular Group Charging System runs from 240kW to 960kW on one master unit, and Megawatt Charging Terminals extend the same shared-power logic to 800kW–1.6MW, MCS-ready, for the heaviest vehicles entering UK fleets over the next decade. Where a site can support it, Power Hub and Power Plant battery storage turns idle capacity into flexibility revenue during the years before drive-up demand alone covers the site's costs, and the Electron platform manages utilisation and pricing across all of it.
This isn't a theoretical pitch. The same modular master-satellite platform is already running two use cases with almost nothing in common at a single site in Qingdao: a liquid-cooled megawatt terminal charging a heavy tanker truck, and a 480kW master unit charging an electric wheel loader on a construction site. Neither vehicle type existed as a mainstream charging customer when most of the UK's current public network was specified — which is exactly the point. Scale that same architecture up and it's what's already running a multi-bay HGV depot in China today: a bank of master-satellite charging cabinets paired with containerised battery storage, servicing a queue of electric tractor units without every bay needing its own oversized transformer connection. The customers who show up in 2029 are not fully known today. The infrastructure should be built to meet them anyway.
Frequently Asked Questions
Why are UK EV charging operators losing money despite record EV sales?
Because charger deployment has outpaced two things at once: usage per device (UK public chargers are active roughly 8% of the day on average) and the cost stack (non-commodity charges like standing charges are up to 462% higher than 2021/22 and now make up as much as 70% of a rapid site's energy cost). Companies House filings for several UK charging operators show balance-sheet insolvency or reliance on continuous parent and investor funding rather than self-sustaining operating cash flow, and more than one well-known UK charging brand entered administration in the first half of 2026.
What does "future-proof" EV charging infrastructure actually mean?
Four concrete things, not a marketing label: modular shared-power hardware architecture that adds capacity without replacing equipment; a grid connection and transformer sized with real headroom and a staged upgrade path rather than maxed out to day-one demand; a software and battery-storage layer that can generate revenue during the years before drive-up utilisation reaches breakeven; and a connector and siting strategy that doesn't assume every bay serves the same vehicle type, since passenger cars, HGVs and electrified construction plant have different duty cycles and power curves.
What is the average utilisation rate of UK public EV chargers?
Roughly 8% of a 24-hour period, or about two hours of active charging per device per day on average, according to Zapmap's utilisation tracking. Industry rule-of-thumb puts commercially healthy utilisation for a rapid or ultra-rapid site at 50% or higher, meaning most UK public chargers are running well below the level needed to cover their fixed costs.
Why do DC chargers become obsolete so quickly?
Vehicle charging curves have moved faster than most fixed-rating hardware. 50kW DC was the mainstream public charging spec in 2020 and is now close to unusable for modern EVs. 240kW dual-gun was the mainstream HGV charging spec two to three years ago and is already considered undersized for current heavy trucks. An integrated charger with a fixed power rating has no path to deliver more power as newer vehicles arrive; only a modular architecture that pools and reallocates power can be upgraded incrementally instead of replaced.
240–960kW MGCS 800kW–1.6MW Megawatt / MCS Master-Satellite Architecture BESS-Backed SitesDon't Let Your Grid Connection Get Specified for Today's Fleet
Send us your site, expected vehicle mix, and available grid capacity. Our engineering team will model a future-proof architecture and a realistic utilisation timeline before you commit to hardware.
Talk to the engineering team
